India DC Review

Power Infrastructure Requirements and Constraints

Electricity is the binding constraint on India's data centre ambitions. Power grid connection timelines, reliability gaps, and tariff structures determine capacity deployment more than capital availability, land, or demand.

← India DC Review
05
India DC Review·28 July 2026·22 min read

Power Infrastructure Requirements and Constraints

Electricity is the binding constraint on India's data centre ambitions. Power grid connection timelines, reliability gaps, and tariff structures determine capacity deployment more than capital availability, land, or demand.

SC
India Energy Atlas
India DC Review · India Energy Atlas
Power Infrastructure Requirements and Constraints hero
India DC Review · Chapter 05

Operational capacity (2025)

1.5 GW

public baseline used by IDCR

IDCR base case (2030)

6.5 GW

operational IT load; 34.1% CAGR

Wood Mackenzie (2030)

12 GW

operational capacity; 2.2 GW baseline

Government planning load (FY32)

+26.3 GW

reported additional AI DC grid load

Live indicators: national peak demand 248.1 GWlive · 03 Oct 2026, 02:11 IST · grid carbon intensity 906 gCO₂/kWhlive · 03 Oct 2026, 01:30 IST · day-ahead price ₹3,420/MWhlast known.

India has 520.5 GW of installed capacity — but data centres need firm, 24/7, high-quality power. India's installed capacity reached 520.5 GW by 31 January 2026 (CEA Installed Capacity Report· CEAJan 2026): coal 227.8 GW, gas 20.1 GW, nuclear 8.8 GW, solar 140.6 GW, wind 54.7 GW, large hydro 51.2 GW, other RE 16.8 GW. Non-fossil sources crossed the 50% threshold in 2025 and now account for over 56% of installed capacity. The live national fuel mix is published on the India Energy Atlas homepage; coal-fleet utilisation is tracked at /coal, the renewables overlay at /renewables, nuclear at /nuclear.

Data centres require firm, 24/7 power at 99.999% (five-nines) reliability — about 5.26 minutes of permitted downtime per year. India's grid delivers 99.7-99.9% reliability across most states. The gap is bridged by diesel generators with 48-72 hours of on-site fuel; this chapter traces why the constraint is power, not capital, and what it takes to convert announced projects into connected, operating load.

India's Power Generation Mix (January 2026)
SourceInstalled Capacity (GW)ShareRelevance to DCsStatus
Coal (thermal)227.843.8%Primary baseload; ~0.82 tCO₂/MWh⚠ Carbon-intensive
Natural gas20.13.9%Potential DC backup (Ch. 6); ~25% PLFEmerging
Solar140.627.0%Intermittent; needs storage/hybridGrowing
Wind54.710.5%Intermittent; southern/western concentrationRegional
Large hydro51.29.8%Seasonal; balancing roleStable
Other RE (small hydro, biomass)16.83.2%Marginal DC relevanceMinor
Nuclear8.81.7%Firm; geographically constrainedStable
Pumped storage4.70.9%18.9 GW planned by 2030Expanding
Battery storage~2.00.4%41.7 GW / 208.3 GWh planned by 2030Critical
Total firm capacity~280~54%Available as firm at any given timeConstraint
India data-centre forecast reconciliation comparing operational capacity and grid-planning load
Forecast reconciliation — operational capacity and grid-planning load are different measures

Forecast Comparison and Methodology

The 27 July evidence update includes a Wood Mackenzie forecast of 12 GW of operational data-centre capacity by 2030 and a parliamentary reply, reported by The Indian Express, indicating 26.3 GW of additional AI data-centre grid load by FY2031-32. Comparison with the IDCR 6.5 GW base case requires consistent definitions, baselines, horizons, and evidence dates.

Forecast comparison — retain the measure, baseline, horizon and cutoff

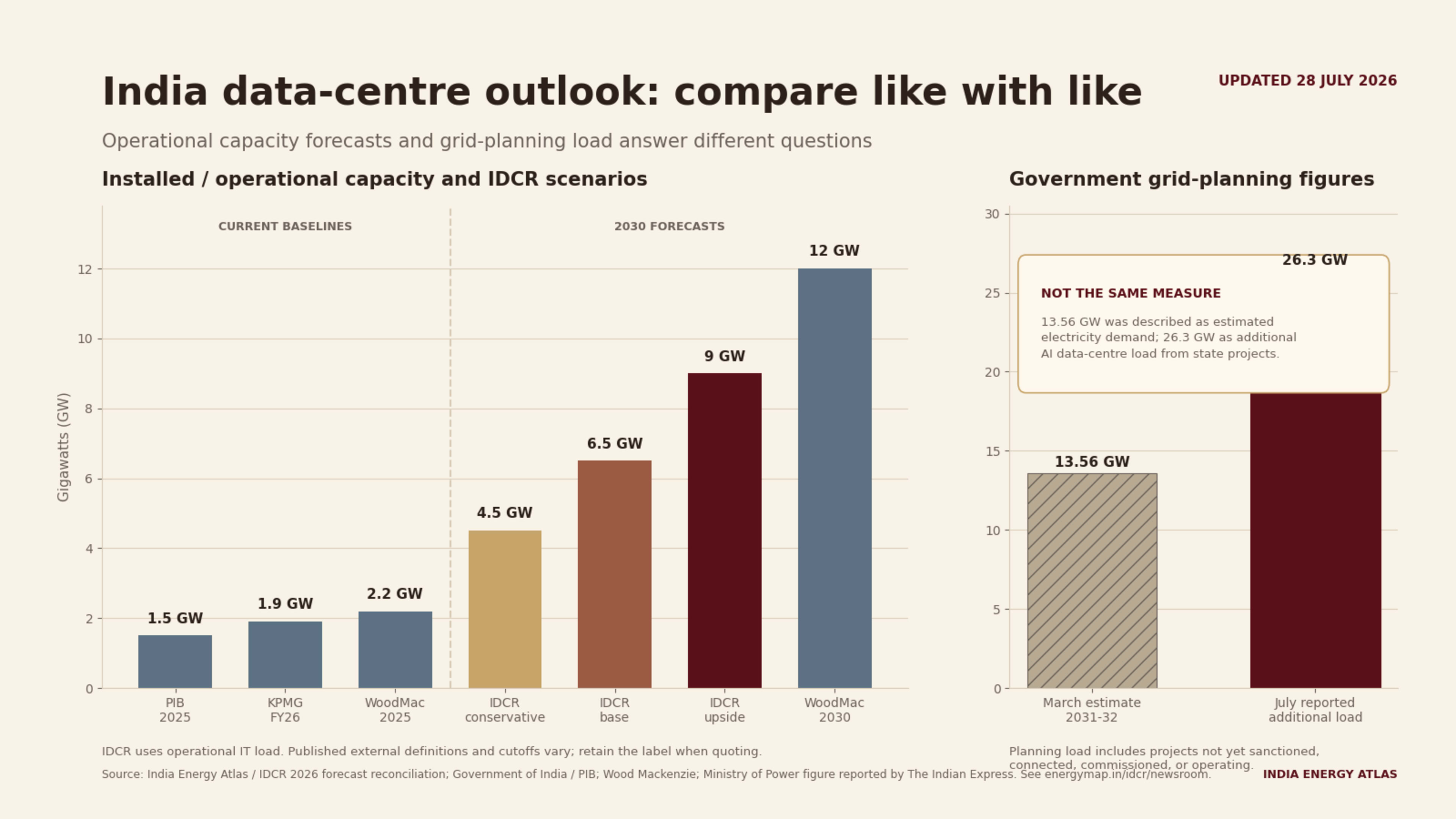

SourceCurrent baselineOutlookMeasureInterpretation
Government / PIB (Mar 2026)1.5 GW in 202513.56 GW by FY2031-32Estimated electricity demand from data centresPublic baseline and earlier planning estimate
KPMG (Jul 2026)~1.9 GW in FY267.0–9.0 GW AI + non-AI demand in FY30Installed capacity / demandLater fiscal-year estimate with a separate cutoff from the PIB baseline
IDCR v2.31.5 GW operational IT load in 20254.5 / 6.5 / 9.0 GW in 2030Operational IT load scenariosConservative / probability-weighted base / upside
Wood Mackenzie (27 Jul)2.2 GW in 202512 GW in 2030Operational data-centre capacityHigh-growth case; ~40% CAGR from a higher baseline
Ministry of Power (reported 27 Jul)Projects received by states+26.3 GW by FY2031-32Additional AI data-centre grid loadGrid-planning estimate requiring separate assumptions for conversion to operational IT capacity

The IDCR base case is 45.8% below Wood Mackenzie's 12 GW forecast. The 9 GW IDCR upside case is 25% below that forecast. The IDCR upside CAGR is 43.1% from a 1.5 GW baseline. Wood Mackenzie reports approximately 40% CAGR from a 2.2 GW baseline. The remaining differences reflect baseline, market coverage, and announced-capacity conversion assumptions.

The 26.3 GW government figure is a grid-planning estimate based on projects received by states. Comparison with operational capacity requires information on project duplication, PUE, diversity, phasing, sanction, connection, commissioning, and utilisation. The March estimate refers to total estimated demand. The July estimate refers to additional AI load. A revision series requires the underlying table and definitions.

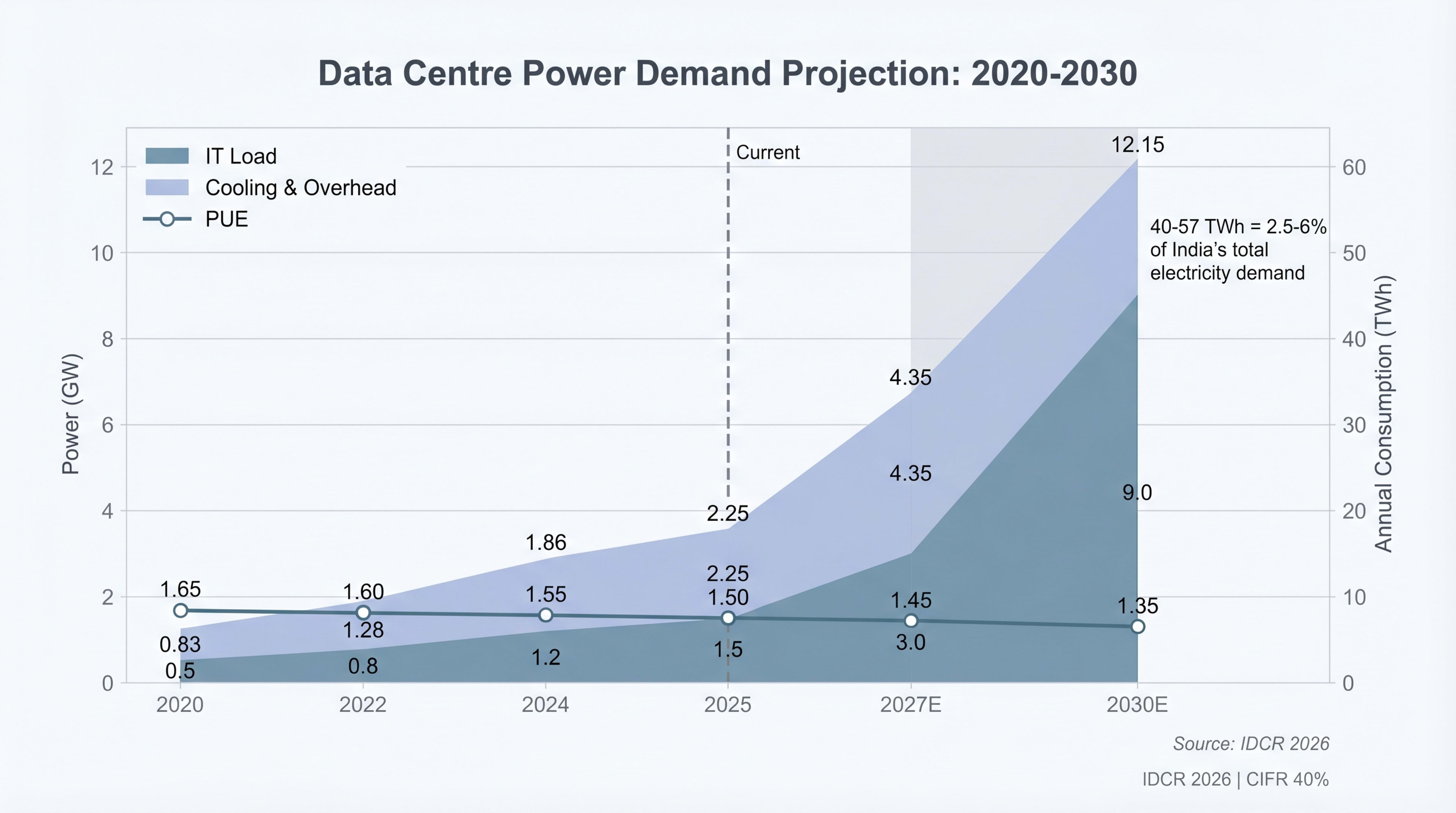

Data centres consumed an estimated 13 TWh in 2024, ~0.8% of India's 1,650 TWh national consumption (S&P Global· S&P Global2025; IEEFA· IEEFA). IDCR retains its operational IT-load scenarios: 4.5 GW conservative, 6.5 GW base, and 9 GW upside in 2030 (see Chapter 14 — Outlook). At 1.35 PUE and 85% average utilisation, those cases imply 6.1–12.2 GW of facility input and 45–90 TWh of annual electricity. The prior 40–57 TWh range is classified as a lower external demand case with separate assumptions.

April 2026 broke the pattern. India met an all-time high peak of 256.1 GW at 15:38 IST on 25 April 2026 — surpassing the prior 250 GW record from May 2024 — and did so while continuing to export to neighbours, with thermal contributing 67% of generation, solar 21%, and hydro 4.4% (Ministry of Power· Ministry of PowerApr 2026). Year-on-year consumption growth for April 1-27 was 8.9%. The grid added 65 GW of fresh generation capacity over FY2026, the largest annual addition on record. Live grid frequency and stability and load forecasts are tracked continuously on the atlas.

IDCR 2030 capacity-to-energy bridge
CaseOperational IT load (GW)Avg PUEFacility input (GW)Avg utilisationAnnual energy (TWh)
2025 baseline1.51.502.2585%~17
2030 conservative4.51.356.0885%~45
2030 base6.51.358.7885%~65
2030 upside9.01.3512.1585%~90
Source: 2025 baseline· Government of India / PIBMar 2026; IDCR 2026 scenario analysis. PUE improvement assumes industry shift to liquid cooling and hot/cold-aisle containment. Annual energy uses 85% average utilisation.
Grid Connection Timeline
Grid Connection Timeline

Securing an HT or EHT connection from a state DISCOM takes 18-36 months in major markets. This — not capital, land, or demand — sets the deployment ceiling.

  • Mumbai (MSEDCL, Adani Electricity, Tata Power): 33 kV and 110 kV connections require load sanction, substation augmentation, and feeder construction. Timeline 18-24 months. Live state load: Maharashtra dashboard.
  • Hyderabad (TSSPDCL): proactive DC policy compresses timelines to 12-18 months for 132 kV. Telangana dashboard.
  • Physical infrastructure — transformers, switchgear, feeder capacity — cannot be manufactured at the pace of facility construction.
Grid connection timeline by city (20+ MW DC load)

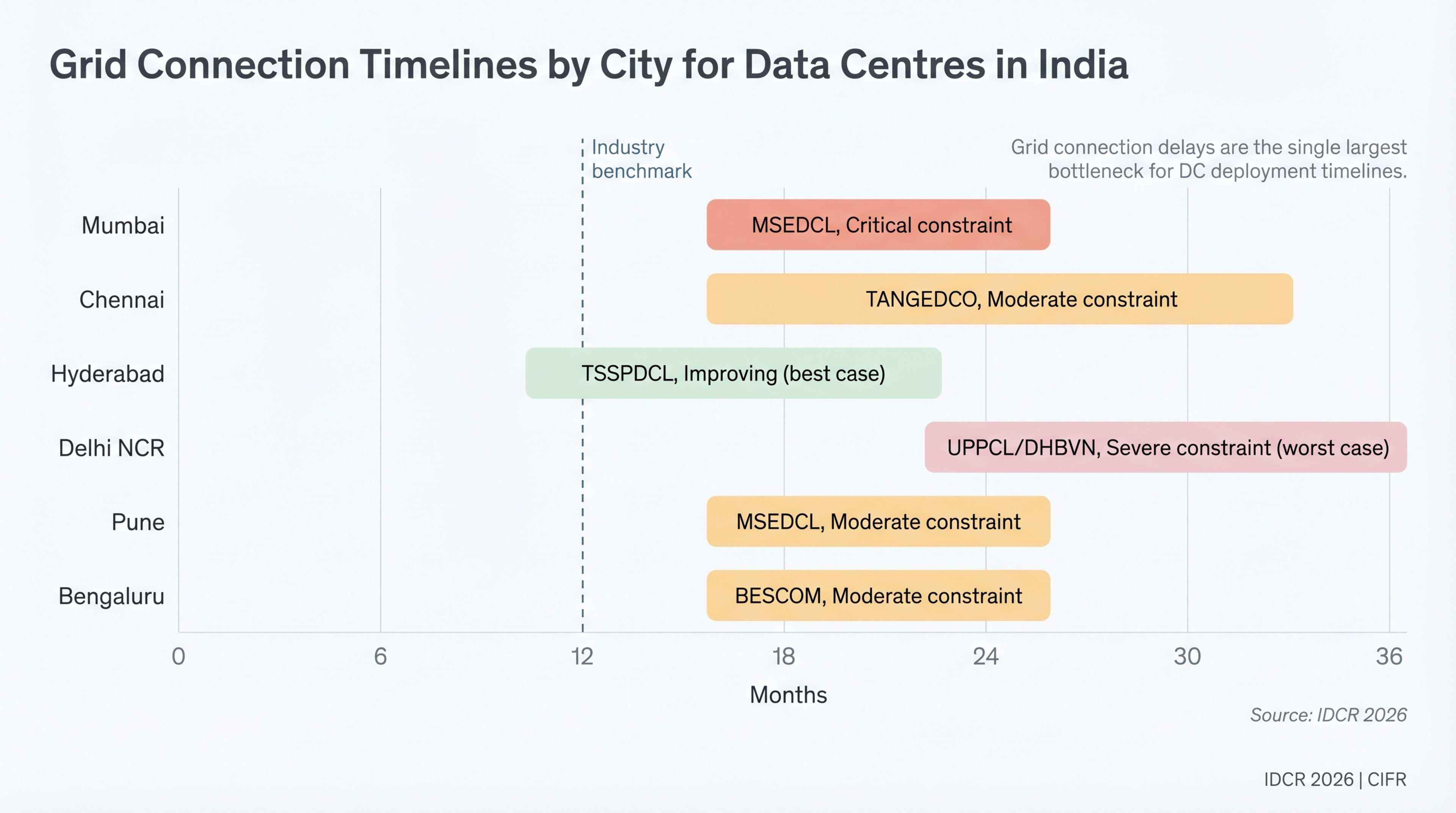

CityDISCOM/UtilityVoltage LevelTypical TimelineBottleneckStatus
MumbaiMSEDCL/Adani/Tata33–110 kV18–24 moSubstation capacityCritical
ChennaiTANGEDCO33–110 kV18–30 moTransformer lead timesModerate
HyderabadTSSPDCL33–132 kV12–18 moNew 132 kV substationsImproving
Delhi NCRUPPCL/DHBVN33–132 kV24–36 moCross-state coordinationSevere
PuneMSEDCL33–110 kV18–24 moRural-to-industrial gridModerate
BengaluruBESCOM33–66 kV18–24 moUrban congestionModerate
Source: IDCR 2026 operator/DISCOM survey; CEEW· CEEW; S&P Global· S&P Global.
Power Tariff Comparison
Power Tariff Comparison

State-Level Power Tariffs: The Hidden Competitive Advantage

State power tariffs create structural cost advantages large enough to override every other location factor. A 50 MW data centre at 85% utilisation and 1.5 PUE faces ₹260 crore/year in Hyderabad (₹5.5/kWh) versus ₹430 crore/year in Mumbai (₹9/kWh) — a ₹170 crore differential, ~$20 M/year. Over ten years, that is $200 M per facility. Hyderabad and Chennai grow faster than Mumbai despite weaker connectivity primarily because of this tariff arbitrage.

India's national weighted average industrial tariff is $0.067/kWh (₹5.6/kWh) — about one-third of Singapore ($0.20/kWh) and half of US rates (CEA tariff order FY2025· CEA). State-level tariffs and DC-specific exemptions are tracked at /tariffs; the tariff-comparator tool models a load profile across states; the /pricing page shows live wholesale power prices.

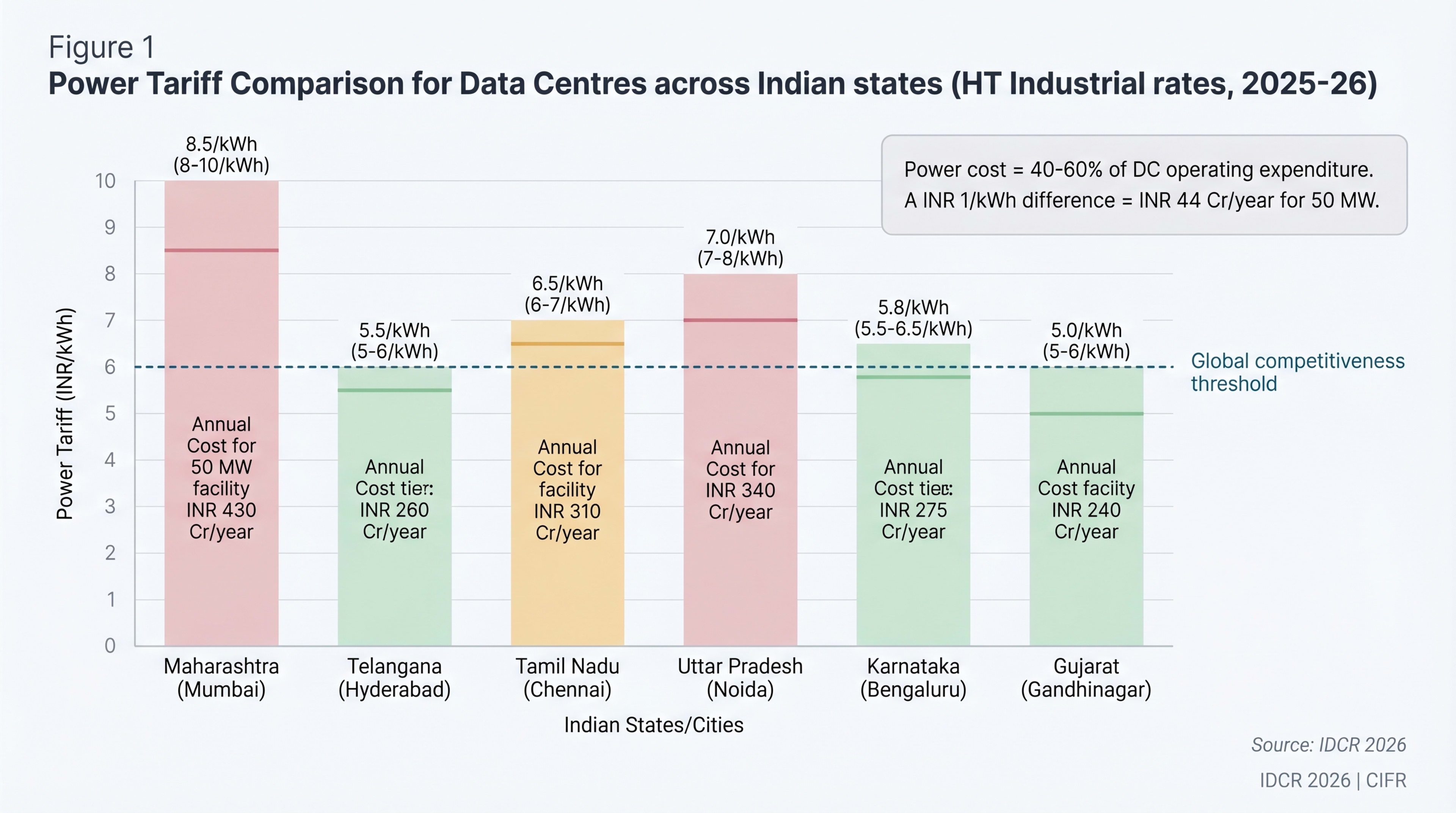

Power tariff comparison for data centres (HT industrial, 2025-26)
State/CityHT Tariff (₹/kWh)DC-Specific IncentiveEffective Rate (est.)Annual Cost (50 MW)
Maharashtra (Mumbai)8–1060% exemption (15 yr)~8.5~₹430 Cr
Telangana (Hyderabad)5–6Subsidised for green DCs~5.5~₹260 Cr
Tamil Nadu (Chennai)6–7IT/ITeS tariff category~6.5~₹310 Cr
Uttar Pradesh (Noida)7–8Exemption under DC policy~7.0~₹340 Cr
Karnataka (Bengaluru)5.5–6.5Exempt (5 yr) + RE savings~5.8~₹275 Cr
Gujarat (GIFT City)5–6SEZ benefits + Adani Green~5.0~₹240 Cr
Source: CERC· CERC; State ERC tariff orders FY2025-26; state DC policy documents; IDCR 2026 estimates.

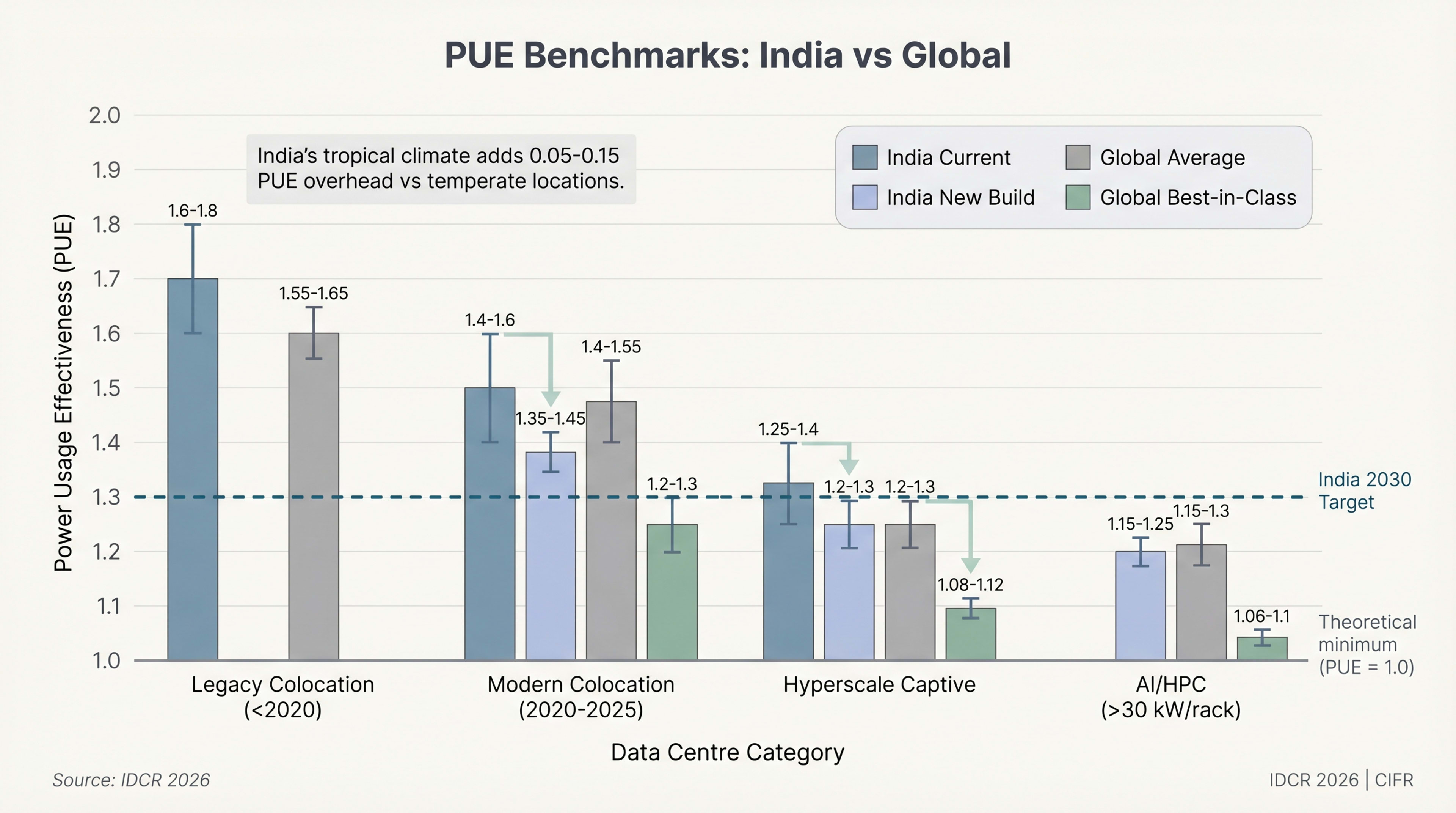

PUE Benchmarks
PUE Benchmarks
“

A 50 MW facility built in Hyderabad pays ₹170 crore less per year for the same kilowatt-hours than one built in Mumbai. Over a decade, that is $200 million per facility — a structural advantage no operational lever can match.

”
— India DC Review · Chapter 05

Data Centres Are Becoming Utilities: The Google–Andhra Pradesh Discom Precedent

The most consequential power-sector signal of 2026 is not a new tariff or a CEA report. It is a state cabinet granting a hyperscaler the legal right to be its own electricity distribution company.

In April 2026 the Andhra Pradesh cabinet approved a power-distribution licence for Google's $15 billion Visakhapatnam data-centre hub — making Google (via its Indian subsidiary Raiden Infotech and a JV with Adani Infra) the first private company in AP to receive a discom licence (Power Peak Digest· Power Peak DigestApr 2026; Varindia· VarindiaApr 2026). Groundbreaking happened on 28 April 2026; commissioning is targeted for July 2028 (Google Press Corner· GoogleApr 2026).

The licence permits Google to procure and distribute electricity directly to its 1 GW campus across Adavivaram, Tarluvada, and Rambilli — bypassing the conventional DISCOM-tariff stack entirely. Three structural implications follow:

  1. Power becomes capex, not opex. Electricity is 40–60% of a hyperscale DC's operating cost. With a discom licence, the operator owns the upstream — long-term PPAs at fixed tariffs, captive renewable integration, and direct grid-balancing relationships with Grid-India· Grid-India. Live Andhra Pradesh grid context: load, fuel mix, and surplus generation profile.
  2. Tariff arbitrage compresses. State competition in the table above (₹5–10/kWh range) was built on DISCOM-mediated industrial tariffs. A discom-licensed hyperscaler effectively negotiates one tier upstream, with state regulators rather than DISCOMs.
  3. The model is replicable. Andhra Pradesh published a parallel framework allowing data centres themselves to apply for distribution licences (Whalesbook· Whalesbook2026). Telangana and Karnataka are watching closely; Maharashtra, with its 18-month MSEDCL queue, faces the hardest political-economy decision.

This is not a one-off concession. It is the regulatory acknowledgement that a 1 GW campus is no longer a customer of a utility — it is a utility, with the same scale of load as a mid-size Indian city. The 2030 power-infrastructure map will be redrawn around which states grant these licences and which do not.
